Canvas 1200CX
Canvas (now JLG Industries / Oshkosh Corporation) · Drywall finishing · Shipping since 2019
Last updated: 2026-04
Summary
The Canvas 1200CX is a battery-powered, worker-supervised drywall finishing robot built on a Universal Robots UR10e cobot arm. It sprays and sands Level 4 and Level 5 joint compound on interior drywall, including L5 skim coating; taping, first coat, corner work, and board hanging stay with the crew. One trained operator runs the robot after a week of training, against the four-year apprenticeship that traditional drywall finishing requires. The 1200CX has shipped since July 2024 and is now distributed by JLG Industries following the January 2026 acquisition; the 1550 predecessor has been in production deployments since 2019.
How it works on your site
Finishing (Second and Third Coats)

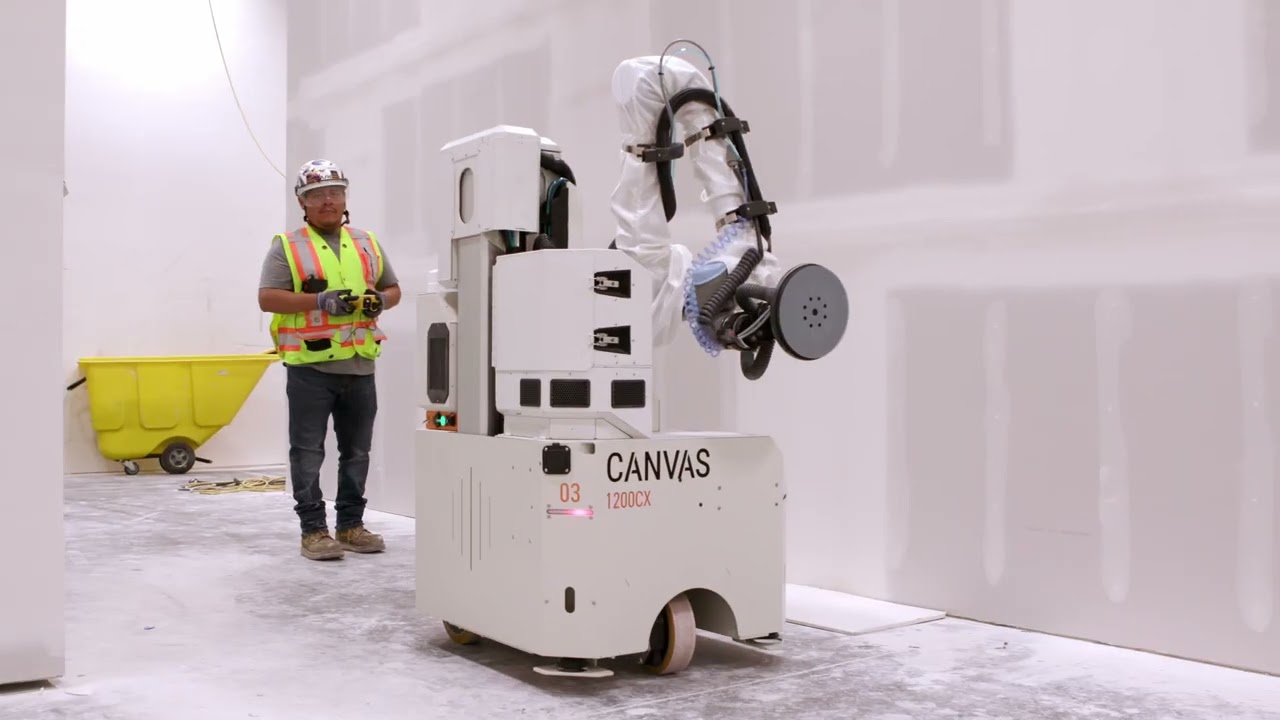

Canvas sprays the L4 and L5 coats and follows up with sanded passes the crew never has to climb scaffold for. Onboard vision identifies taped seams and walls without pre-mapping; one mode targets only the seams (L4 Targeted Spray) while another sprays full surfaces. The crew continues to do taping, corners, and complex geometries while the robot handles the spray and sand passes.

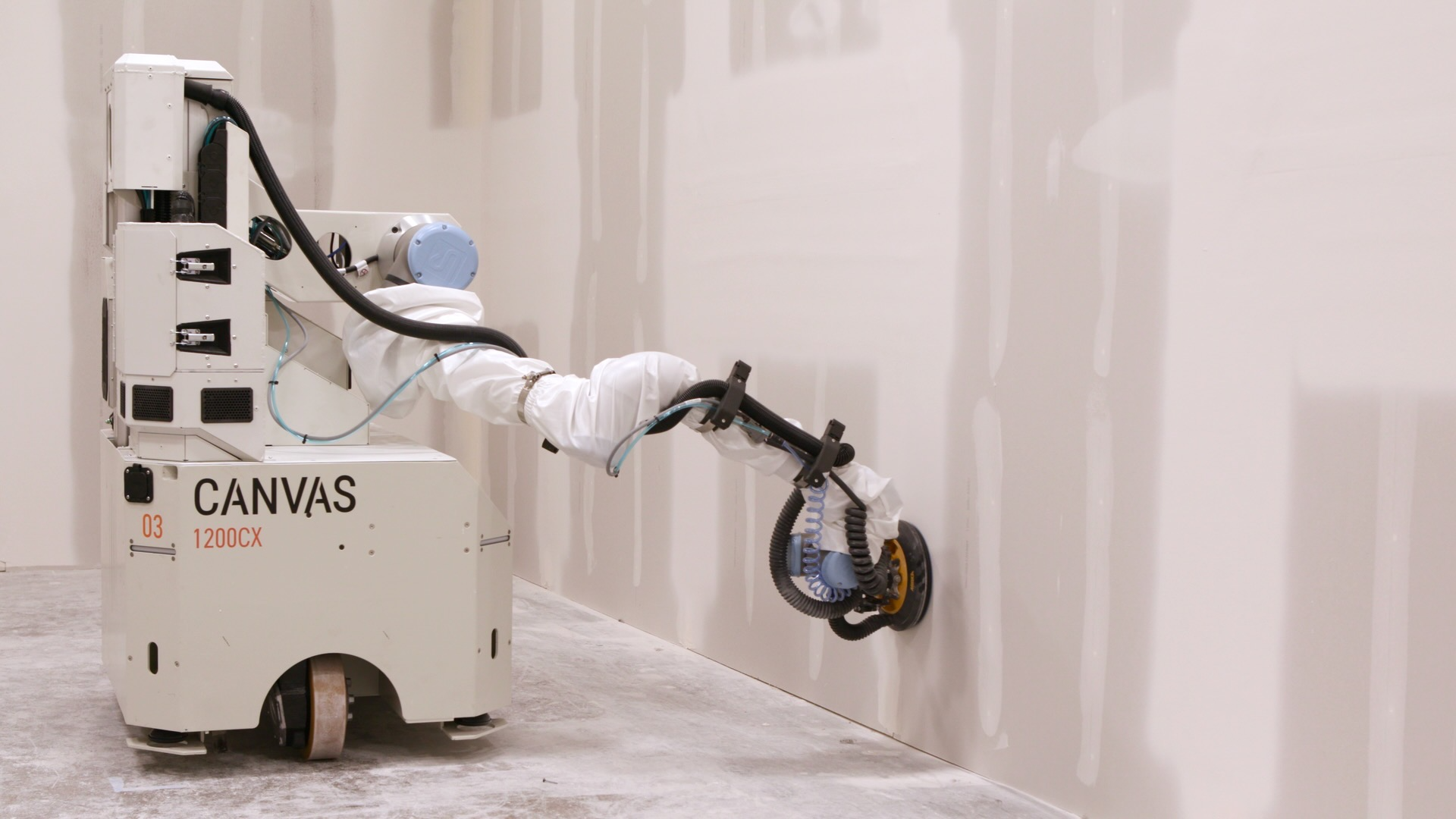

Sanding
Sanding is paired with both L4 and L5 spray passes; the same robot that sprayed the wall returns and sands it. The capture system is designed to pull silica exposure off the crew during what is otherwise the dustiest part of the finishing job.
Skim coating (Level 5 only)
L5 skim coat is the surface where vendor sites lead with marketing and contractors push back hardest on quality. The 1200CX handles L5 within reach; the 1550 predecessor reaches taller spaces.
How it worked on other sites
Webcor at SFO International Airport Terminal B
Airport interior finishing · San Francisco, CA · Two-year engagement
- Two-year production engagement on L4 and L5 finishing across large continuous drywall installations.
- Quality exceeded expectations (Todd Mercer, Webcor VP Strategic Innovation).
- Workflow validated: crew kept taping and corners; robot handled spray and sand passes.
RQ Construction across multiple projects
Interior finishing · USA + Cuba · Multi-project ongoing
- About 25% reduction in drywall labor across the project, roughly 85.5 hours saved.
- About 50% reduction in coat and drying schedule for L5 finish.
- Numbers measured on the 1550 predecessor; not yet replicated on the 1200CX.
Hensel Phelps and Nevell at Sunnyvale Civic Center Modernization ($174M)
Municipal interior finishing · Sunnyvale, CA · Level 5 drywall finish
- Hensel Phelps PM Andrew Cameron called the L5 finish "outstanding".
- Nevell Group CEO Chris Taylor confirmed a multi-year, multi-machine lease.
- A Canvas-trained Nevell employee operated the robot.
Robot also used by
